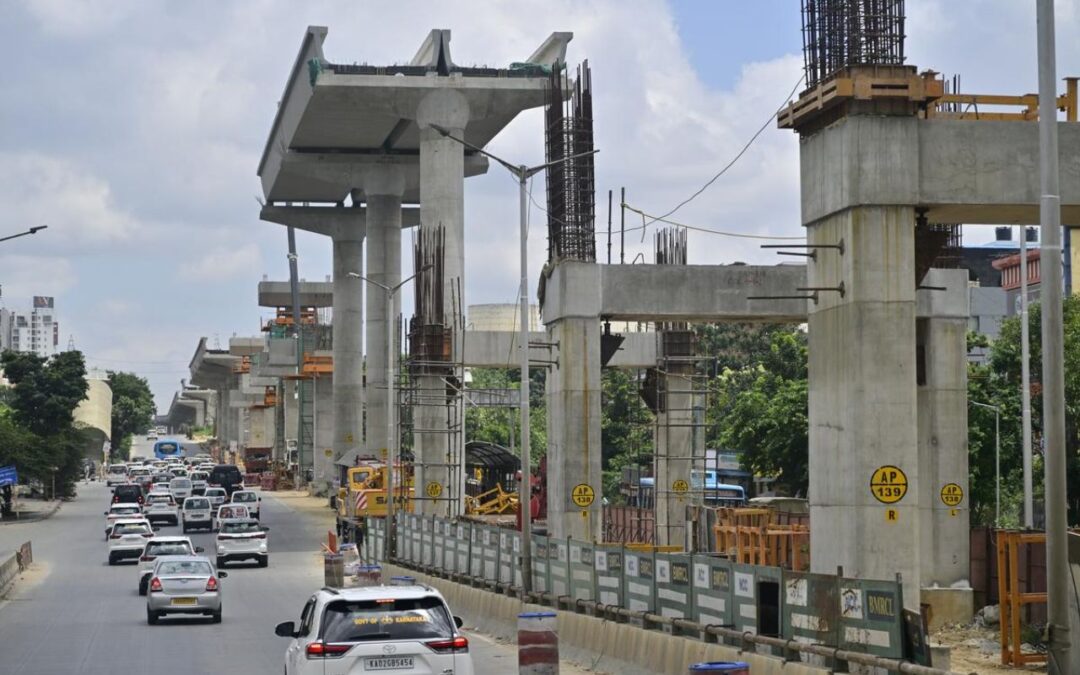

Synopsis: The GBA is building flyovers, underpasses and railway overbridges that are being built to alleviate traffic congestion and connectivity issues in Bengaluru. While there have been some projects delayed, they are all important to building the city’s road infrastructure and future urban development.

With the ongoing urbanization of Bengaluru, the need for good infrastructure in the city has become a necessity to decongest the city and facilitate the growth of the city population. The Greater Bengaluru Authority (GBA) is coordinating a series of flyovers, underpasses and railway overbridges along the city’s major corridors to resolve the longstanding traffic congestion issues in the city. These projects are designed to boost connectivity and shorten travel times, but a number of them have experienced delays in the development process, including problems with land acquisition, the relocation of utilities, contractor problems, and coordination difficulties.

1. Ejipura–Kendriya Sadan Flyover Project

  • Location: Connects Ejipura and Kendriya Sadan in South Bengaluru. Passes through the St. John’s Hospital corridor.
  • Length: 2.38 km
  • Expected Completion: October 2026
  • Built By: Greater Bengaluru Authority (GBA)
  • Segments
  • Total planned: 762
  • Cast so far: 728
  • Remaining: 15 spans
  • Purpose: To reduce traffic congestion along the busy Ejipura–Kendriya Sadan corridor. To improve connectivity between key areas such as Koramangala, Hosur Road, and the Inner Ring Road.
  • Area Involved: Approximately 5,998.6 sq. m of government and private land.
  • Project Cost: ₹203.20 crore

2. Yelahanka Flyover Project

  • Location: Yelahanka, North Bengaluru.
  • Length: 1.8 km
  • Expected Completion: 2026
  • Built By:  Greater Bengaluru Authority (GBA)
  • Structure: Four-lane flyover.
  • Purpose: To provide a signal-free corridor across four major junctions in Yelahanka. To reduce congestion and improve connectivity between Yelahanka, Doddaballapur, and other North Bengaluru areas.
  • Area Impacted: Yelahanka, Doddaballapur, and surrounding North Bengaluru regions.

3. RR Nagar Arch Flyover Project

  • Location: Near the RR Nagar Arch on Mysuru Road, South-West Bengaluru.
  • Length: Ramp 1: 305 m (0.305 km), Ramp 2: 350 m (0.350 km) and Total Length: 655 m (0.655 km)
  • Project Cost: ₹71.45 crore
  • Expected Completion: Currently stalled, with no revised completion timeline announced.
  • Built By: Bruhat Bengaluru Mahanagara Palike (BBMP)
  • Structure: Two flyover ramps:
    • Ramp 1: Kenchanahalli Main Road to Mysuru Road.
    • Ramp 2: University Circle to Vrishabhavati Valley.
  • Purpose: To ease congestion at the RR Nagar Arch junction on Mysuru Road. To provide smoother connectivity for commuters travelling to Banashankari 6th Stage, BEML Layout, Channasandra, and Uttarahalli.
  • Area Impacted: Rajarajeshwari Nagar and surrounding South-West Bengaluru localities.

Also read: Bengaluru Metro Expansion: 5 Upcoming Metro Corridors That Could Create the City’s Next Real Estate Hotspots

4. Jakkur Railway Overbridge (ROB) Project

  • Location: It connects Jakkur Village and Yelahanka Main Road in North Bengaluru. Located near the railway crossing adjacent to Jakkur Lake.
  • Length: 600 metres (0.6 km)
  • Project Cost: Over ₹27 crore
  • Expected Completion: mid-June 2026.
  • Built By: BBMP/Bengaluru North City Corporation (BNCC).
  • Structure
    • Railway overbridge above the active railway line. Approach ramps on both sides. Includes an underpass for smaller vehicles and a pedestrian pathway.
  • Purpose: To eliminate delays at the railway crossing and provide a direct connection between Jakkur and Yelahanka. To reduce travel distance from 5–6 km to around 2 km for commuters and school buses.
  • Area Impacted: Jakkur, Yelahanka, Hennur, Nagavara, and surrounding North Bengaluru localities.

5. Jalahalli Cross Grade Separator (Underpass) Project

  • Location: Jalahalli Cross junction in North-West Bengaluru. Located at the intersection of NH-4 (Tumkur Road), Subroto Mukherjee Road, and Peenya Industrial Ring Road. Near Jalahalli Metro Station.
  • Length: Approximately 70 metres (main underpass section).
  • Expected Completion: late 2027 or early 2028.
  • Project Cost: Nearly ₹170 crore, Civil construction: ₹57.2 crore and land acquisition is over ₹139 crore.
  • Built By:  BBMP, GBA
  • Structure
    • Four-lane, bi-directional underpass. Slip roads towards Gangamma Circle and Peenya. Includes footpaths, drainage infrastructure, and pedestrian subways.
  • Purpose: To reduce congestion at the heavily trafficked Jalahalli Cross junction. To separate highway traffic from local traffic heading towards the Peenya Industrial Area and improve pedestrian safety.
  • Area Impacted: Jalahalli, Peenya, Dasarahalli, and surrounding North-West Bengaluru localities.

6. Okalipuram Eight-Lane Corridor Project

  • Location: Connects Majestic and Rajajinagar in Bengaluru.
  • Expected Completion: June 2026
  • Built By: BBMP, GBA
  • Structure
    • Two box-pushing structures beneath the Chennai railway line. Eight-lane traffic corridor. Connecting roads to Rajajinagar and the railway station. Footpaths and a proposed pedestrian foot overbridge.
  • Purpose
    • To improve connectivity between Majestic and Rajajinagar by easing traffic movement.
    • To reduce flooding and waterlogging through upgraded drainage infrastructure.
  • Area Impacted: Majestic, Rajajinagar, Okalipuram, and surrounding central Bengaluru localities.

7. Wind Tunnel Road Underpass Project

  • Location: ISRO Junction on Old Airport Road, East Bengaluru.
  • Length: 300 metres
  • Project Cost: ₹19 crore
  • Expected Completion: November 2026.
  • Built By: Greater Bengaluru Authority (GBA).
  • Structure: Underpass with prefabricated structural boxes. Retaining walls and service roads. Around 60% of the structural boxes have already been fabricated.
  • Purpose: To eliminate congestion at the busy ISRO Junction and create a seamless signal-free corridor. Expected to reduce commute times by 15–20 minutes while lowering fuel consumption and emissions.
  • Area Impacted: Murugeshpalya, Konena Agrahara, HAL, Domlur, HAL Stage 2, and Belur Nagasandra.

Conclusion

The GBA’s plan to undertake road infrastructure projects is expected to have a significant impact on improving the connectivity and reducing congestion in the city. There were delays in a few projects, but their upcoming completion will help to enhance Bengaluru’s transport system, ensuring the city keeps moving forward.

Written by Boyapati Sai Jasmitha
